Honeysuckle Operations Directives
The HOD
The HOD was instigated by Mike Dinn when he came on board as Tom Reids Deputy in 1967.
It was used to document ops procedures to be followed at HSK.
The basis was the GSFC supplied procedures, but these always needed condensation, clarification, addition and adaptation to local conditions. Also most operators had there own little black book or cheat sheets dealing with their own specific equipment and procedures, but these could differ from person to person and shift to shift. And could also become out of date.
So the decision was taken to produce the HOD, including all these procedures, encouraging everybody to contribute, and ensuring that the HOD was up-to-date.
A major requirement of the HOD was to ensure that it never conflicted with the official documentation, as GSFC were understandably nervous when they found us using our own documentation, especially when conducting on-site sims. I think we achieved this.
There was some resentment when introducing the HOD, at least initially. Ill let others explain why. It might have been part of the inevitable management /worker or Department (of Supply)/Contractor relationship. But I think it came to be accepted with time. One opponent told me that he eventually generated an equivalent document when he moved to a new job.
Mike Dinn January 2004
|

Cover
|
Spine |

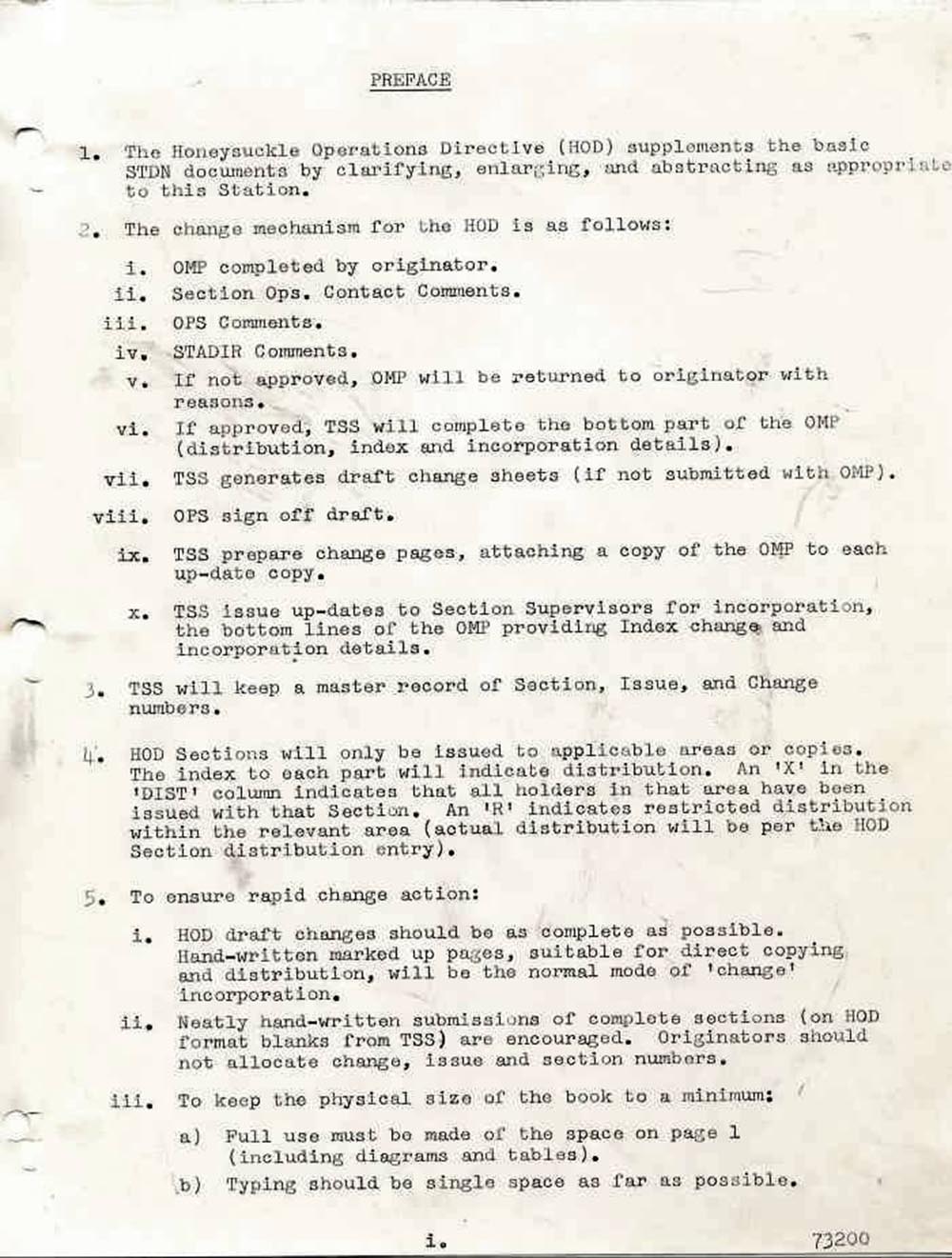

Preface |
|

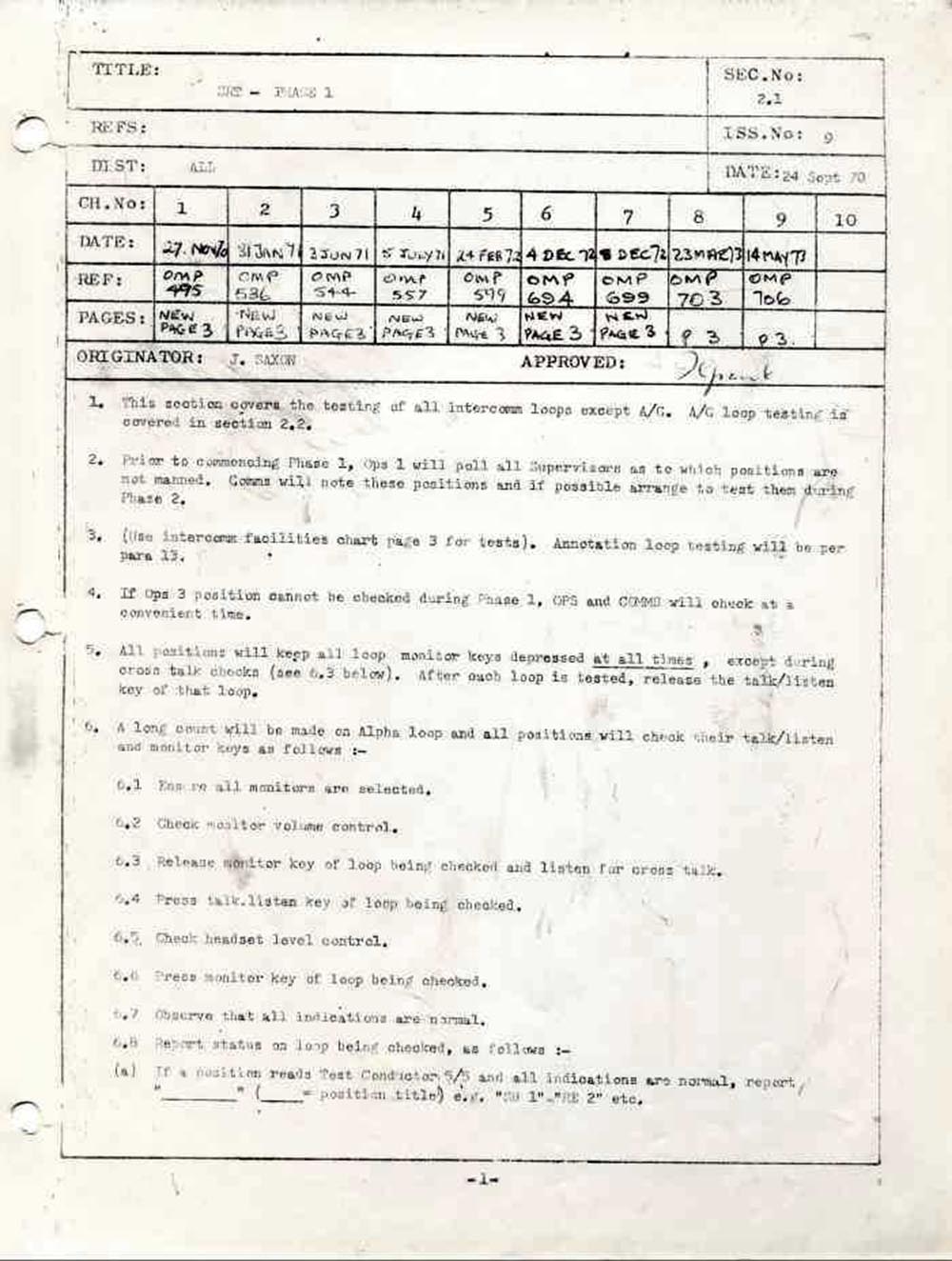

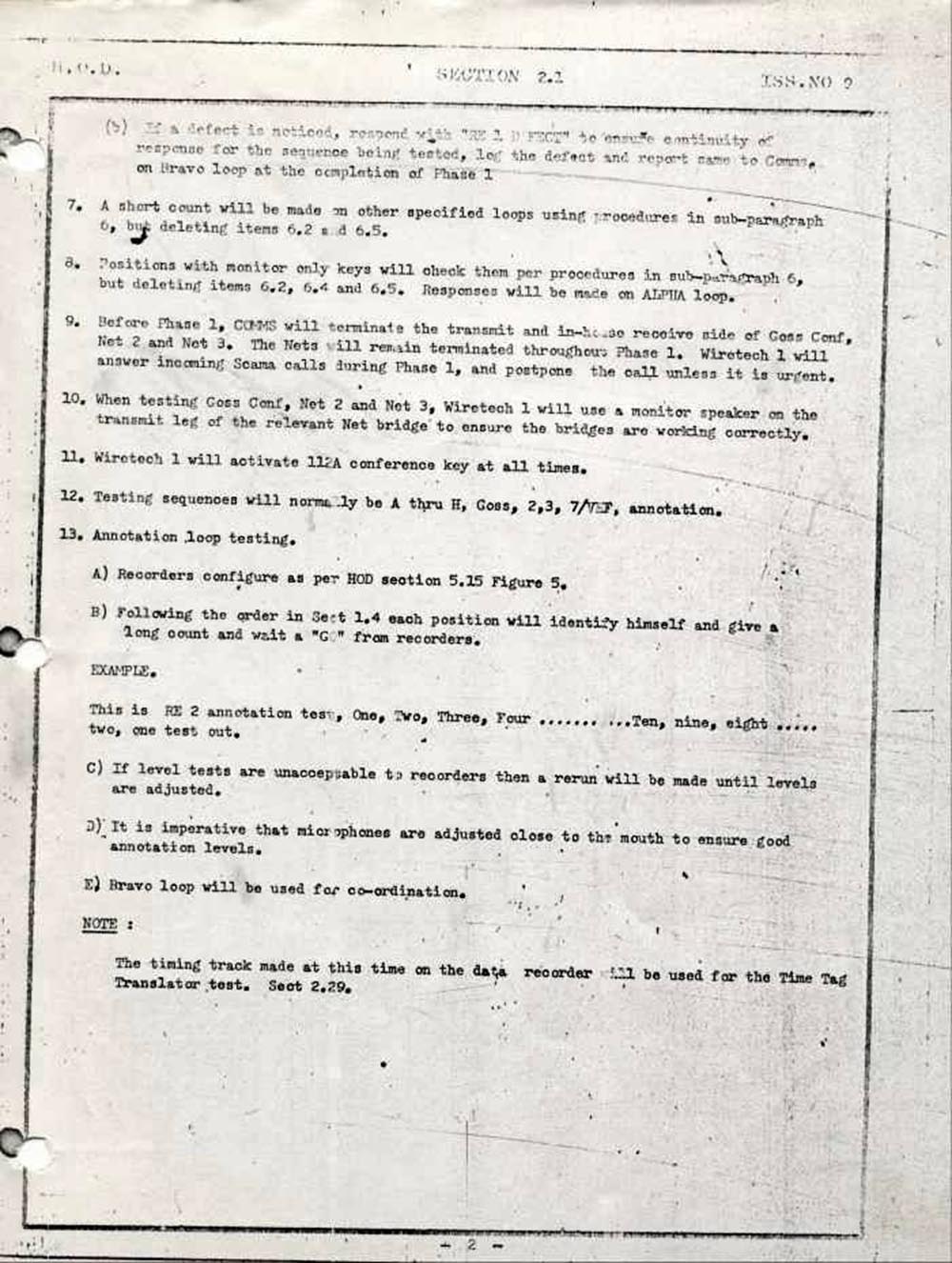

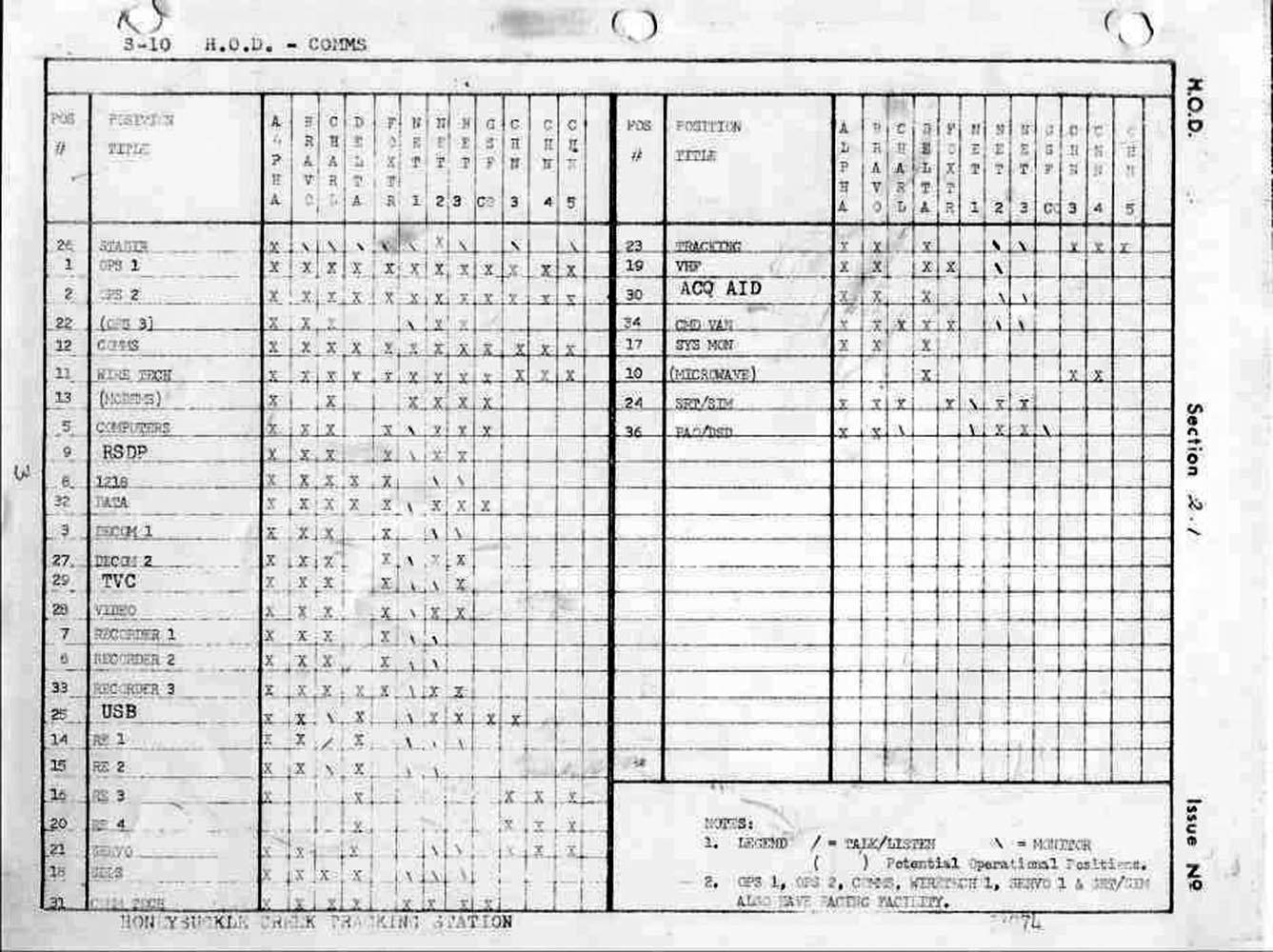

SRT Phase 1 (Intercomm Test)
|
||
|
Page 1 |
Page 2 |
Page 3 |
For each, click on the image to see the larger version in a new window
Hamish Lindsay writes
Here is a caricature I did of Mike when he put out this alien document.
We were all slaves to the NASA bible the Network Operations Directive, Volumes 1, 2, and 3 plus Supplements it was absolute law. I was always intrigued that Mike always wore dark sunnies, even when he came on shift at midnight. So I drew this Roman scribe in sunnies with an expression of you lot WILL follow my Directive, or else.
In the background are the discarded
three volumes and Supplement of the NOD sitting on a plush cushion. My Technical
Support Section, holding the Master Copy, bore the brunt of keeping this document
up to date many, many hours were spent copying all the changes before
every mission, and distributing all the pages to every copy around the station.
|
This is the illustration on the HOD spine above. |
